Activity
Networks: Determining the critical path
Most scheduling software will identify the critical path for you, but
it is important that you understand the process. We are going to use

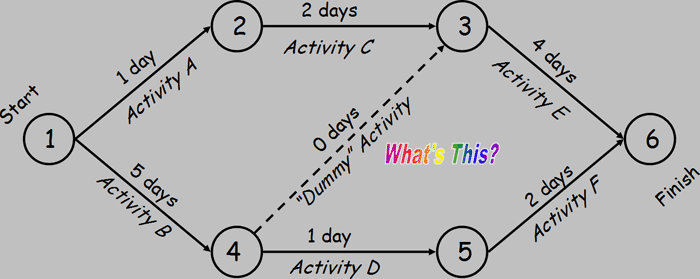

this Activity-on-Arrow diagram to illustrate how to determine the critical
path.

Click the image above to hear an explanation.
|
