Activity
Networks: The new product launch as an example

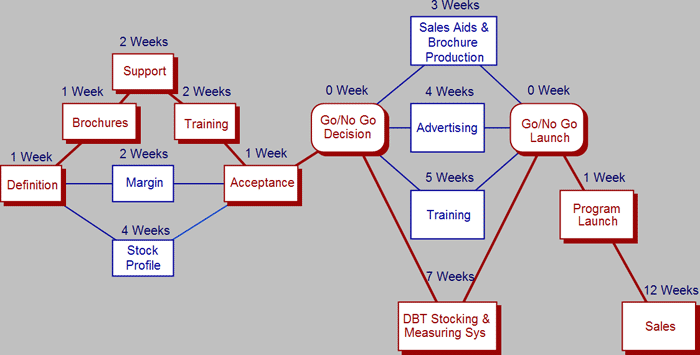

This PDM diagram represents the sequence of activities for the New Product
Launch project that we saw earlier. Add the duration estimates in each
parallel path. Which path is the longest addition of durations? What
is the shortest time this project can be completed, without “fast-tracking” or “crashing?” Confirm
that the critical path is the one called out in red. Did you get 27 weeks?
|
