What will it cost to accelerate the schedule? (continued)

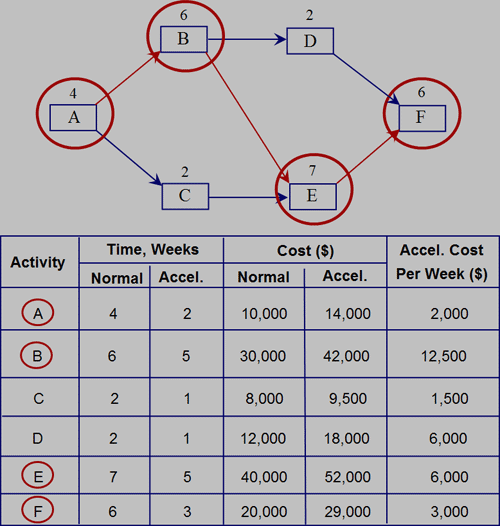

The critical path is shown in red on this diagram, and the cost per week to shorten each task is given in the last column of the table.
