Resource Infeasible 8-Day Schedule (continued)

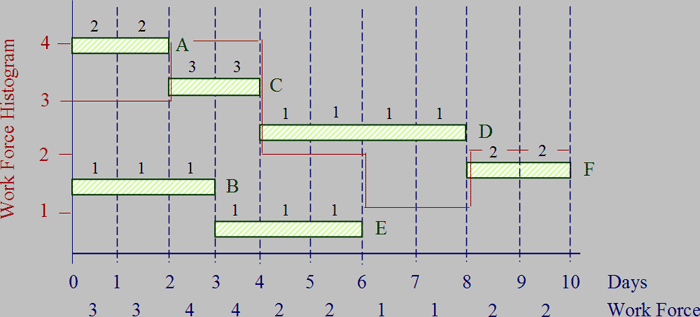

The result is a resource feasible schedule, 10 days long rather than 8 days long.

Leveling resources within time constraints occurs often in project management, and it can become an activity trap. You can’t force 3 cups of milk into a 2 cup jar. Something’s got to give: time, resource or scope. In this example, the resource constraint controls, and time must be extended to maintain the same scope.
