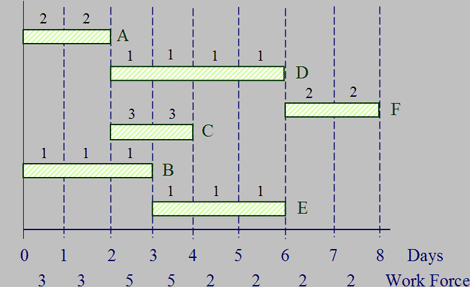

Resource
                  Infeasible 8-Day Schedule (continued)
                  How are we going to deal
                  with this? There are several possibilities:

                  -

 Ask
                          the task leader of “C’ if the work could be
                          done with 2 people in 3 days. If he or she says “yes”,
                          the problem is solved.



                  -

Move “C” downstream
                          within available slack. This does not work, as it just
                      moves the
                          need for 5 people downstream.



                  -

A
                          resource feasible solution is to move “C” into
                              the A-D-F critical path. The only logic constraint on “C” is
                        that it must follow “A,” as does “D.”

                    |
